CONSTRUCTION ESTIMATE TEMPLATE

Free construction estimate template

A construction estimate priced phase by phase — demolition, permit, footings, framing, finishes, cleanup — with a contingency line and a deposit to begin. Free in Word and PDF, with every line explained.

Word and PDF · Free · No email, no sign-up

The short answer

A construction estimate lists the job by phase, each phase on its own line with its labor and materials: demolition and disposal, permits, footings and foundation, framing, the finishes (decking, railing, siding, roofing), cleanup — and a contingency line, usually 5–10%, that is released if it isn't needed.

Phases matter because a customer compares your estimate against two others. “Deck — $17,800” is a number they argue with; eight phases that add up to it is a plan they can follow, and the first place they'll see what a cheaper estimate left out.

Around the phases go your business and license details, the customer and the site address, the estimate number and the date it holds until, the deposit and the payment schedule, and the two paragraphs customers read first: what's included and what isn't.

FREE TEMPLATE · WORD AND PDF

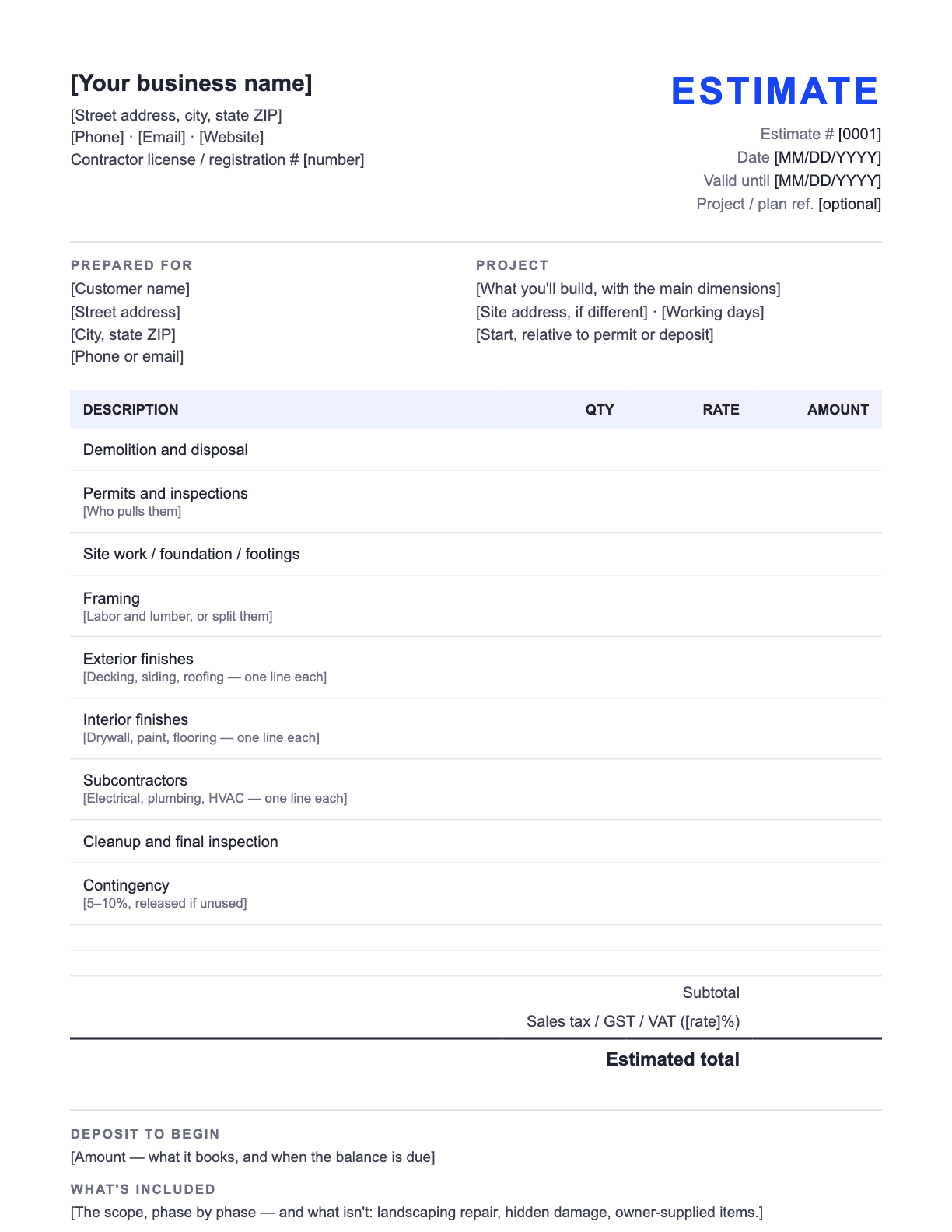

The construction estimate template, filled in

Below is the template filled in for Ridgeline Builders, a fictional construction business, so you can see every line in use. The downloads are the same estimate with [bracketed] lines to replace — free, no email address, no sign-up.

Example · fictional business

DescriptionQtyRateAmount
Demolition and disposal of existing deck
Remove 12 × 16 ft wood deck, haul and dump fees
1$850.00$850.00
Building permit
City of Spokane, pulled by us
1$310.00$310.00
Footings and posts
6 footings to frost depth, 6 × 6 posts, hardware
1$1,450.00$1,450.00
Framing
Pressure-treated beams, joists at 12 in. on center, ledger with flashing
280$18.00$5,040.00
Composite decking and fasteners
280 sq ft, hidden fasteners, color to be chosen
280$14.00$3,920.00
Aluminum railing
54 linear feet, black, with post caps
54$62.00$3,348.00
Stairs
4 risers to grade, composite treads, railing both sides
1$1,200.00$1,200.00
Cleanup and final inspection1$350.00$350.00
Contingency, 5%
Unknowns in the ground or the ledger — released if unused
1$820.00$820.00
Subtotal$17,288.00
Sales tax, 8.9% on the whole job (example — Washington taxes custom construction in full)$1,538.63
Estimated total$18,826.63

Deposit to begin

$1,800.00 books the job; the balance is due when the work is finished.

What's included

Everything above, including the permit, inspections and daily cleanup. Not included: landscaping repair beyond the deck footprint, electrical for deck lighting, and any repair to the house wall found when the old ledger comes off — we'll show you and price it before we continue.

How to pay

Deposit by card, check or bank transfer to book the start date and the material orders; $8,000 when framing passes inspection; the balance when the job is finished.

Every figure on the example is an example, not a price guide — use your own rates. The Word file is a standard .docx you can edit in Word or any app that opens Word documents; the PDF prints as-is if you'd rather fill it in by hand.

Quotes and a website, one place

Start your construction website — quoting is built in

Add your business name and your town, and Zarla builds your construction website from this one line. The same dashboard sends quotes like this one as a link your customer accepts online, and drafts the invoice when they do.

No credit card · Pay when you publish

Already have a website? Bring it across →Zarla keeps your old page addresses where it can and redirects the ones that change, helping you keep the Google standing you've built.

See construction website examples

LINE BY LINE

What goes on a construction estimate

Every line on the template, in order, and what to write on it.

The lines of a construction estimate, top to bottom
The lineWhat to put there
Business name, contact and contractor registrationYour trading name, phone, email and address, and your contractor license or registration number — most US states require it on bids, and customers check it.
Estimate number, date and valid-until dateA number that never repeats, the date, and the date the price holds until. Lumber and composite prices move; 30 days is common, 14 when they're volatile.
Prepared for and site addressWho's paying and where the work is. On a rental or a new build the owner isn't always on site — name both.
The project in one line, with dimensions“New 14 × 20 ft composite deck with railing and stairs” — the size is what the customer compares across estimates.
Demolition, permits and site workRemoving what's there and the dump fees; the permit and who pulls it; footings, grading or foundation. Each on its own line.
Framing and finishesFraming as labor and lumber (together or split), then each finish on its own line: decking, railing, siding, roofing, drywall, paint, flooring. Mark customer-chosen finishes as allowances.
SubcontractorsElectrical, plumbing and HVAC on their own lines, so the customer sees the licensed trades inside the price.
Contingency, tax, total and depositA 5–10% contingency the customer can see (released if unused), sales tax where your state charges it, the estimated total, and the deposit with the payment schedule.
Included and how to payScope in, scope out (hidden damage, landscaping repair), the deposit and the payment schedule, and how to pay.

STEP BY STEP

How to write a construction estimate

An hour at the desk after the site visit, from your takeoff to a document the customer can approve.

01

Describe the project with its dimensions

What you'll build and how big, where, how many working days, and when you can start relative to the permit or the deposit.

02

Break it into phases

Demolition, permits, foundation, framing, each finish, each subcontractor, cleanup. One line per phase is the shape every other contractor's estimate will be compared against.

03

Price labor and materials from your takeoff

Quantities from the plan (square feet of decking, linear feet of railing, number of footings) × your unit prices. Mark finishes the customer chooses later as allowances.

04

Add the contingency and the permit

A visible 5–10% contingency for what's in the ground or behind the wall — released if unused — and the permit fee with who pulls it.

05

Set the deposit and the payment schedule

A deposit that covers material orders, progress payments tied to inspections or milestones, and the balance on completion. Check your state's deposit cap.

06

Write the scope and send it the same week

What's included, what isn't, the deposit and the payment schedule, and how to pay. The estimate that arrives first sets the price in the customer's head.

How construction estimates win the job

Show the phases, not just the total. Customers collect three estimates and the cheapest one usually left something out — the permit, the dump fees, the railing. When yours lists every phase, the customer can see what the other number is missing, and your price looks like a plan instead of a guess.

Make the contingency visible. A line that says “Contingency, 5% — released if unused” reads as honesty; the same money buried in the framing line reads as padding. When you don't need it, it comes off the final invoice and the customer remembers that.

Tie payments to inspections. “Progress payment when framing passes inspection” gives the customer a reason the money is due that isn't your say-so. It also keeps your cash flow ahead of your material bills.

Allowances for anything the customer chooses. Decking color, railing style, tile — put a stated allowance on the line and say that the difference is added or credited when they choose. The estimate stays honest without you guessing their taste.

Tax. In the US, sales tax on construction work depends on your state — some tax only the materials, some tax the whole job, and the rule can change between new construction and repair — so keep materials and labor on separate lines and check your state's revenue department or your accountant. Outside the US the rule is the other way around: in Australia and New Zealand a GST-registered business gives a consumer a price that includes GST, and in the UK and EU a VAT-registered business shows the VAT and quotes consumers a price with it included. Confirm the details with your accountant.

Send it from Zarla and get it accepted online

A Word estimate is a fine way to start. The slow part is everything after you send it: waiting for a reply, wondering whether they opened it, and retyping every line into the invoice when they say yes.

If you build your construction website with Zarla, quotes are in the same dashboard. Build the quote from your own price book — one price, or up to three options side by side with the one you'd pick marked Recommended, and any line as a checkbox extra. Send it as one link, by email. Your customer picks an option, ticks any extras, types their name to accept, and gets a copy; Zarla drafts the invoice for exactly what they chose, with any deposit you asked for, and the job moves to Won. The quote template is already in your brand: your website's logo, colors and fonts, set once for every quote and invoice. On a paid plan, with your Stripe account connected, that invoice carries a pay-now button, so the deposit comes in as soon as you send it.

Want to see the website first? Browse construction website templates or see how Zarla builds construction websites. Still setting up? Read how to start a construction business and write your construction business plan.

The whole paper trail of a job, step by step: how to write a quote, then the construction invoice template, then how to write a receipt — with a free receipt template. For any other trade, start from the free estimate template.

Construction estimates: common questions

What should a construction estimate include?

Your business, contact and contractor license details; the customer and the site address; an estimate number, the date and a valid-until date; the project in one line with its dimensions; every phase on its own line — demolition, permits, foundation, framing, finishes, subcontractors, cleanup; a visible contingency; subtotal, tax where it applies, the estimated total, the deposit and the payment schedule; and what's included, what isn't, and how to pay.

What's the difference between an estimate, a bid and a quote in construction?

An estimate is your best calculation of what the job will cost, given what you can see today; the final price can move if the work turns out different. A quote (or a fixed price) is the price you will charge for the work described. A bid is a quote submitted against someone else's specification, usually in construction. Say which one your document is in its title.

How much contingency should a construction estimate carry?

Five to ten percent of the price is usual for residential work — more for remodels and anything where you can't see the structure until demolition. Put it on its own line, say what it's for, and say it's released if unused; that's the difference between a contingency and padding.

How long should a construction estimate be valid?

Thirty days is the common choice for a home-services estimate, and shorter when material prices move (roofing, lumber, copper). Print the date on the estimate: a customer who comes back after it can be re-quoted at today's prices without an argument, and one who accepts inside it knows the price holds.

How much deposit can a contractor ask for?

Enough to cover the materials you order before the job and the weeks you've blocked out — 10% to a third of the price is the usual range. Some US states cap the deposit a contractor may take before work starts; check your state's licensing board.

Is this construction estimate template free?

Yes. The construction estimate template on this page downloads free as a Word document and a PDF — no email address, no sign-up. Edit it in Word or any app that opens Word documents, or print the PDF and fill it in by hand.

Can customers accept the estimate online?

Not from a Word file — the customer replies by email or phone, and you type the job into an invoice later. To get a yes in one tap, send it from quoting software. If your construction website is on Zarla, the quote tool is in the same dashboard: your customer opens one link, picks an option, ticks any extras and types their name to accept, and Zarla drafts the invoice for what they chose — which, on a paid plan with Stripe connected, carries a pay-now button. Jobber, Housecall Pro, Wix and Squarespace send quotes customers accept online too.

Send estimates from your own construction website

Add your town and your business name, and Zarla builds the site from that one line — with quoting in the same dashboard.

No credit card · Pay when you publish

Already have a website? Bring it across →Zarla keeps your old page addresses where it can and redirects the ones that change, helping you keep the Google standing you've built.

See construction website examples
